DataVonix

cloud infrastructure migration

A financial services company had been running critical business systems on ageing on-premise servers for over a decade.

Industry
Financial services
Category
Cloud Services
Core stack
AWS · ECS Fargate
  • What it is

    A full cloud infrastructure migration to AWS

  • Who it's for

    A financial services company

  • What it does

    Moved 14 applications, 3 databases and 60TB of data to AWS with zero downtime

the problem we were asked to solve

Cloud migrations in the financial services sector carry enormous risk. Any downtime on core systems directly impacts revenue and client trust. Regulatory compliance (FCA guidelines) required all data to remain within UK AWS regions. The legacy systems included a mix of Windows Server 2008 applications, Oracle databases, and custom-built middleware - many of which had no documentation and some that had not been touched in years.

The client's internal IT team had no AWS experience, meaning DataVonix needed to not only execute the migration but also upskill the team and establish operational procedures for the new cloud environment.

how it works, step by step

  1. 01

    Assess

    Every application and database is mapped and planned.

  2. 02

    Migrate

    Applications move in planned waves.

  3. 03

    Shift traffic

    Traffic moves to AWS gradually, with zero downtime.

  4. 04

    Optimise

    Spend is cut once everything runs in the cloud.

see it in action

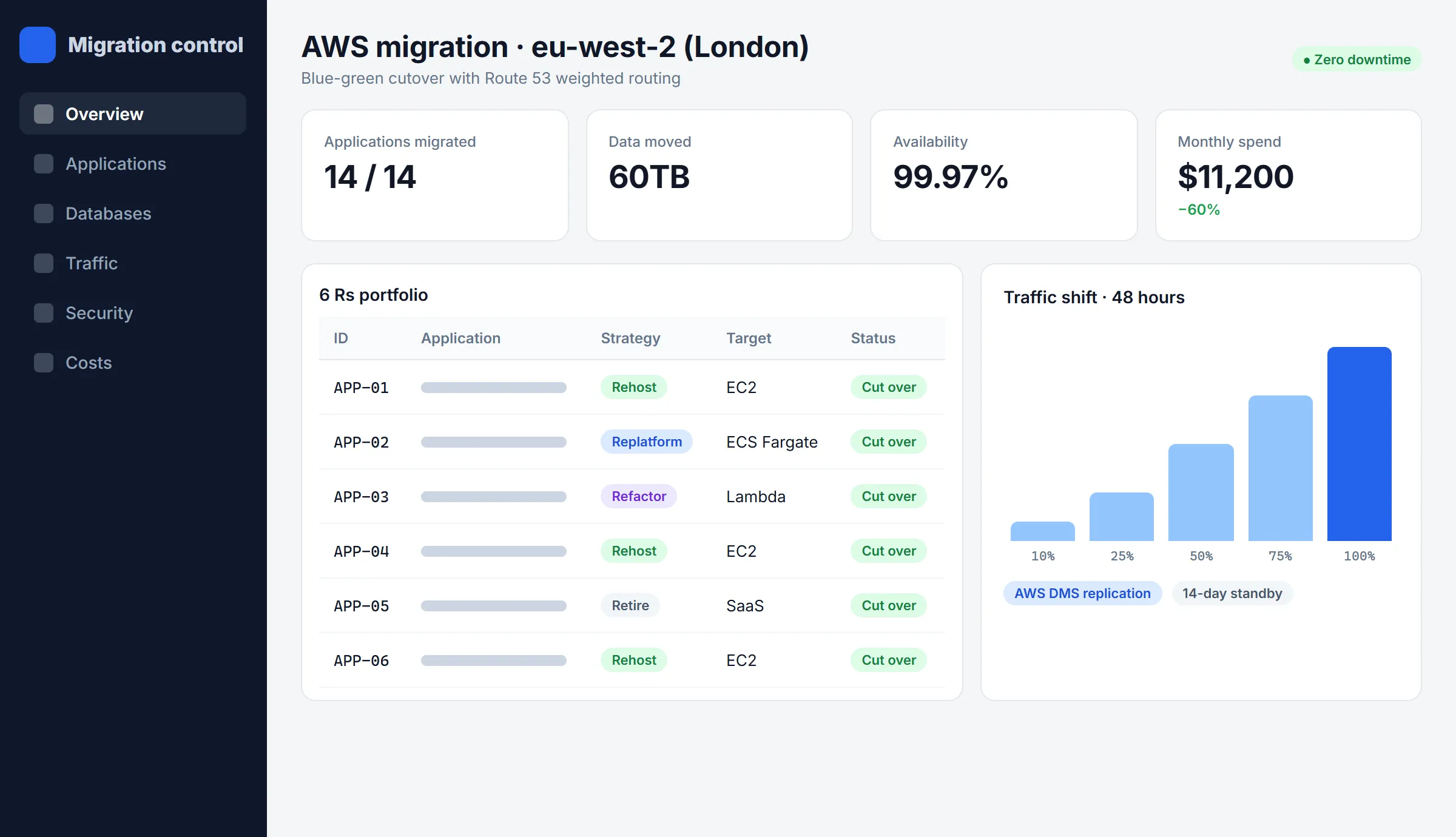

Cloud Infrastructure Migration: the main screen
The main screen
Cloud Infrastructure Migration: on a phone
On a phone
Cloud Infrastructure Migration: in the browser
In the browser
Cloud Infrastructure Migration: in use
In use

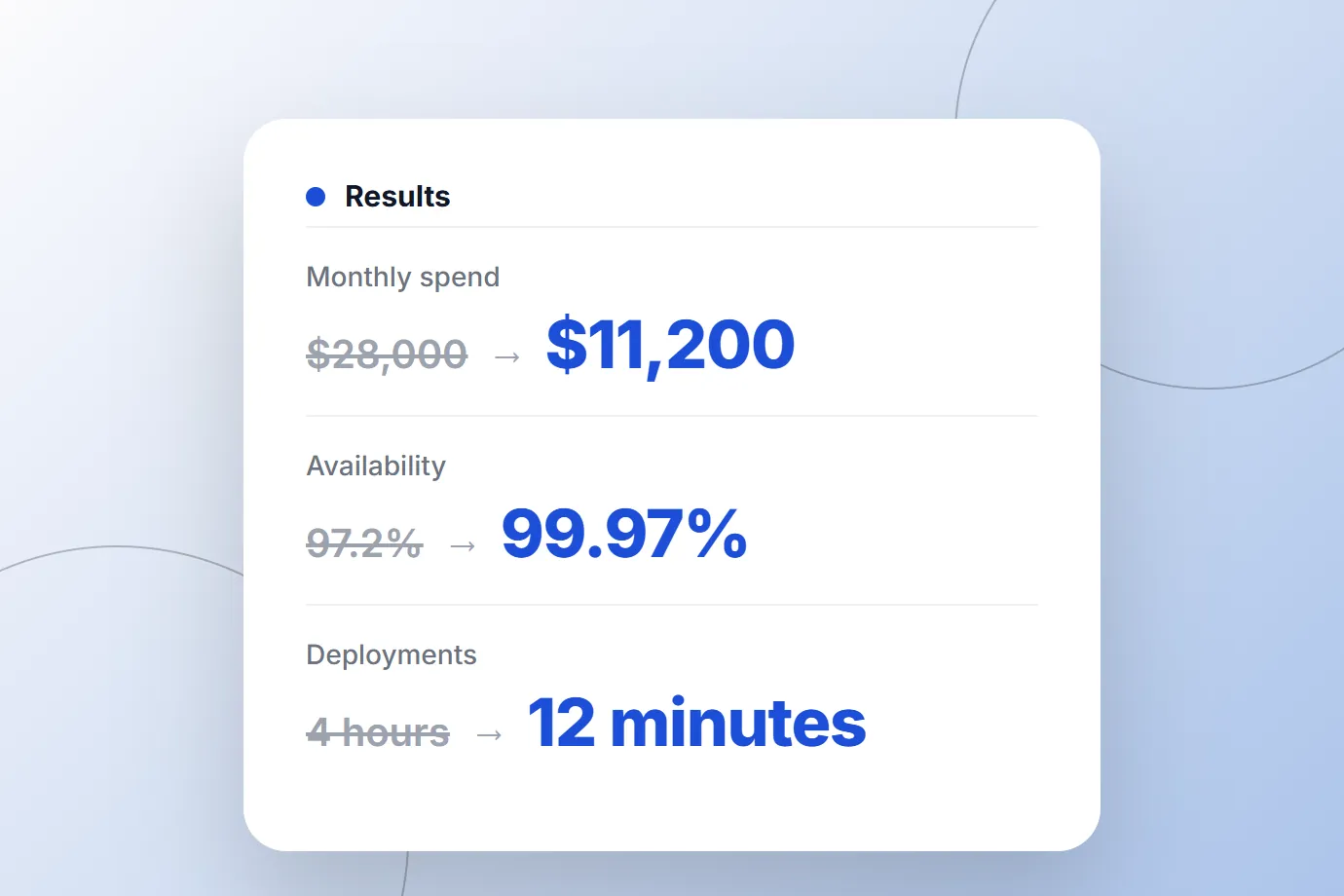

what changed for them

  • Zero downtime

    Zero downtime during migration cutover across all 14 applications

  • $28,000 to $11,200 per month

    Infrastructure spend reduced from $28,000 to $11,200 per month (60% saving)

  • 97.2% to 99.97%

    System availability improved from 97.2% to 99.97% year-on-year

  • 4 hours to 12 minutes

    Deployment time for application updates reduced from 4 hours to 12 minutes (CI/CD pipeline)

  • 40%

    Database query performance improved by 40% on RDS vs. legacy Oracle hardware

  • RTO of 15 minutes

    Full DR (Disaster Recovery) capability established with RTO of 15 minutes vs. 8+ hours previously

how it's built

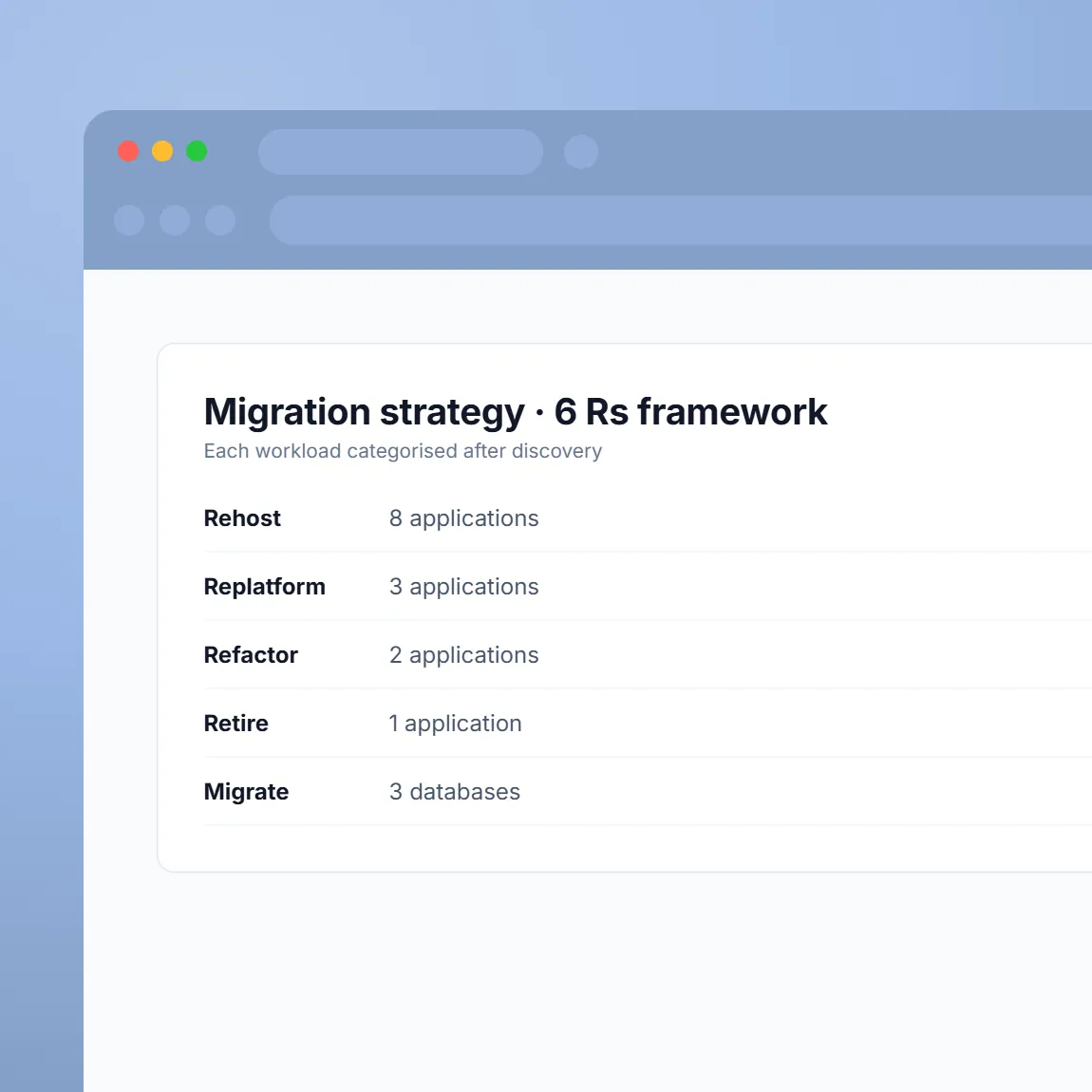

DataVonix used Amazon's 6 Rs framework to categorise each workload: Rehost (lift-and-shift), Replatform, Refactor, Repurchase, Retire, or Retain. After a thorough discovery phase, the portfolio broke down as follows:

The migration used a blue-green deployment model. Each application was stood up in AWS in parallel with the on-premise system. AWS Database Migration Service (DMS) handled continuous replication of database changes during the transition period. Once the AWS environment was validated and load-tested, traffic was switched over via Route 53 weighted routing - starting at 10% and increasing to 100% over 48 hours. The old systems remained on standby for 14 days post-cutover before decommissioning.
